MSP Onboarding: How to Transition Cloud Operations Without Big-Bang Risk

How to transition cloud operations to a managed service provider safely: a five-phase onboarding plan with knowledge transfer, shadowing and parallel operations.

Irfan Harees

Irfan Harees · Senior Program Manager – Research, Marketing & Strategy

· 4 min read

Share
Five labelled onboarding phases stacked in order, the last lit and in the provider's hand: a phased MSP handover.

The riskiest moment in any managed services relationship is the beginning. Knowledge sits in people's heads, documentation is incomplete and the outgoing team is busy. A rushed handover can mean the first major incident lands on a team that has never seen the system.

This guide explains an MSP onboarding process that avoids big-bang risk.

The riskiest moment in any managed services relationship is the beginning.

Why do MSP transitions fail?

  • Handover compressed into days to save cost
  • Undocumented systems and tribal knowledge
  • Access and tooling not ready on day one
  • No period of supervised operation before cutover
  • Unclear responsibilities between client, outgoing and incoming teams

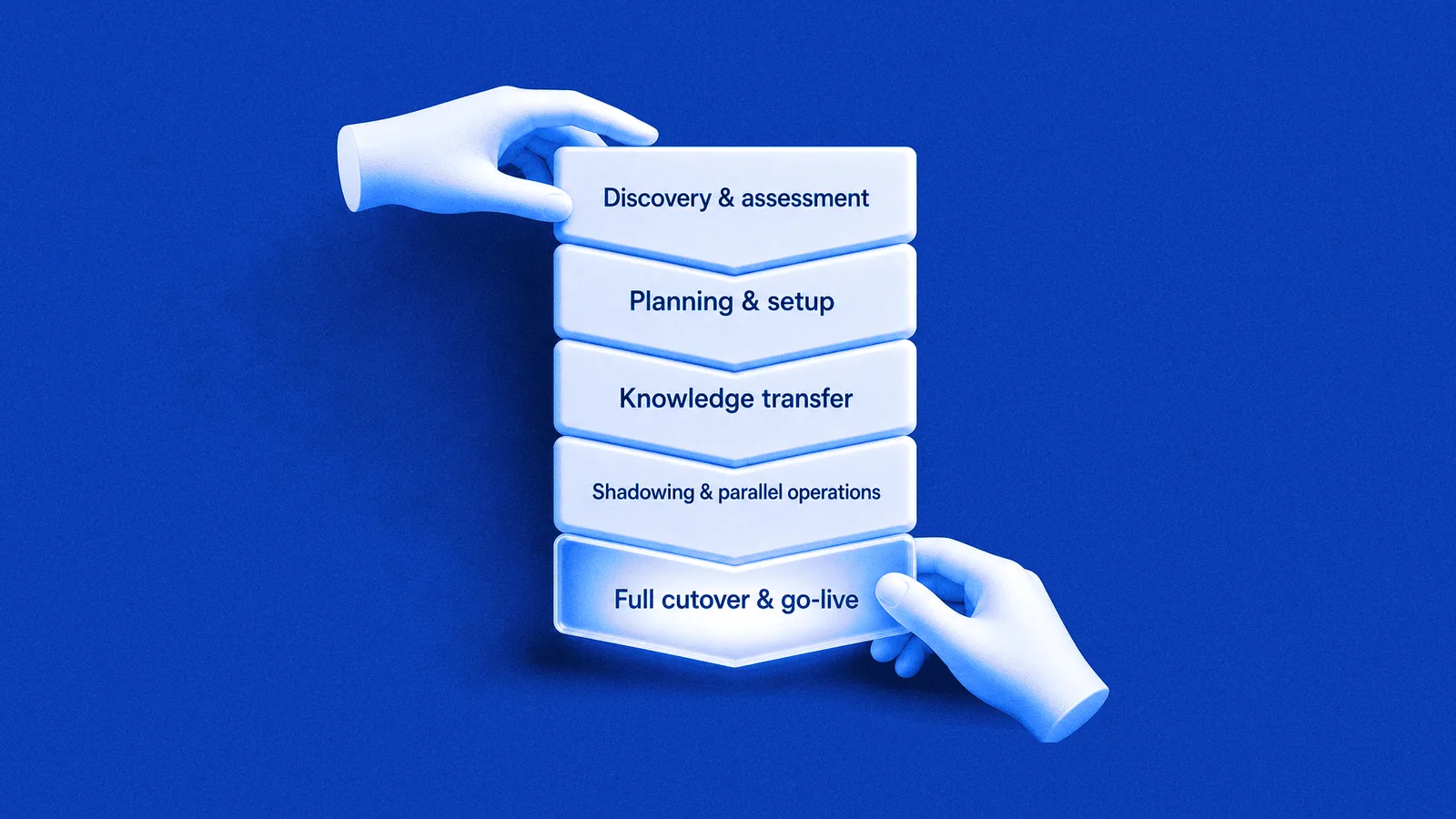

The five-phase MSP onboarding plan

Phase 1: Discovery and assessment

Inventory environments, accounts, applications, dependencies, monitoring, backups, security controls and known issues. Identify risks and constraints.

Exit criteria: complete inventory, risk register, agreed scope.

Phase 2: Planning and setup

Set up access with least privilege, connect monitoring and alerting, establish ticketing and escalation paths, and draft runbooks. Agree a RACI and communication plan.

Exit criteria: access working, monitoring live, runbooks drafted, escalation matrix agreed.

Phase 3: Knowledge transfer

Structured sessions with your engineers on architecture, deployment processes, recurring issues and business-critical periods. Record sessions and update documentation.

Exit criteria: documented architecture, validated runbooks, sign-off from system owners.

Phase 4: Shadowing and parallel operations

The MSP works alongside your team: first shadowing, then leading with your team observing. Incidents and changes are handled jointly.

Exit criteria: MSP has handled real incidents and changes successfully; client confident.

Phase 5: Full cutover and go-live

The MSP takes full operational responsibility under the agreed SLAs. Hypercare, with extra attention and daily check-ins, continues for the first weeks.

Exit criteria: SLAs met through hypercare, first monthly service review held.

Who does what during onboarding?

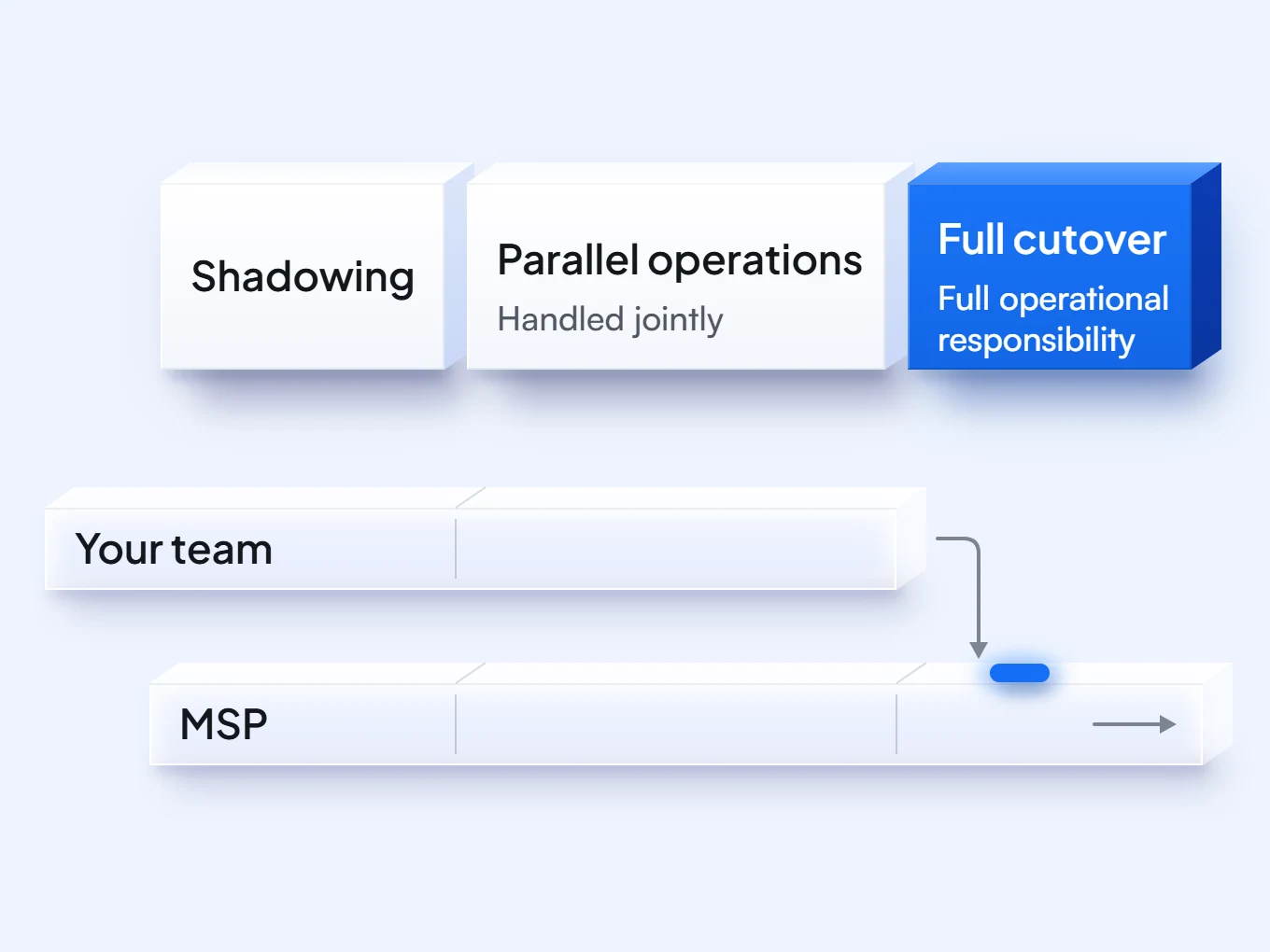

Your team and the MSP overlap through shadowing and parallel operations; responsibility moves to the MSP only at full cutover.
Both teams handle incidents and changes during the overlap; the MSP takes full responsibility only at full cutover.
ActivityClientMSP
Provide access and contextResponsibleConsulted
Inventory and assessmentConsultedResponsible
Runbook creationReviewsResponsible
Knowledge transfer sessionsResponsible (presenters)Responsible (learners)
Parallel operationsSharedShared
Go/no-go decisionAccountableRecommends

How long does MSP onboarding take?

For most environments, four to twelve weeks, depending on size, number of clouds and documentation quality. Complex, multi-cloud estates with many legacy systems take longer. Resist pressure to shorten shadowing and parallel operations; that is where risk is removed.

What should you prepare as the client?

  • Architecture diagrams, even rough ones
  • List of critical systems and business calendar (peak seasons, month-end)
  • Known issues and workarounds
  • Contacts for vendors and third parties
  • Access approvals and security requirements
  • Time from your engineers for knowledge transfer

How Crozaint onboards clients

Crozaint's onboarding follows five phases: Discovery & Assessment, Planning & Setup, Knowledge Transfer, Shadowing & Parallel Operations, and Full Cutover & Go-Live. We run alongside your team before taking full responsibility, so there is no big-bang risk.

Once live, our ITIL-based service model, escalation matrix and SLAs (30-minute response for P1 and P2) apply across all eight service disciplines. The same approach underpins our observability engagements, which run parallel migrations instead of forced rip-outs.

Common mistakes to avoid

  • Skipping parallel operations to hit a date
  • Starting before access and monitoring are ready
  • No exit criteria for each phase
  • Releasing the outgoing team before knowledge transfer is complete
  • No hypercare after go-live

Conclusion

A good MSP relationship starts with a careful transition. Assess, prepare, transfer knowledge, run in parallel and only then cut over.

Planning a transition? Tell us what you're running in a 30-minute call with Crozaint.

Frequently Asked Questions

How long does it take to onboard a managed service provider?

Most cloud MSP onboardings take four to twelve weeks, depending on environment size, number of clouds, documentation quality and complexity. The phases of knowledge transfer, shadowing and parallel operations should not be rushed, because they remove most of the transition risk.

What is parallel operations in MSP onboarding?

Parallel operations is a phase where the incoming MSP runs operations alongside the existing team. Both handle incidents and changes together, first with the MSP observing, then leading. It lets the MSP prove readiness on real work before taking full responsibility.

What documentation is needed for an MSP transition?

Key documents include architecture diagrams, an inventory of accounts and resources, runbooks for common operations and incidents, deployment processes, backup and DR procedures, access lists, vendor contacts and known issues. The MSP should create or improve these as part of onboarding.

What is hypercare after go-live?

Hypercare is a period of heightened attention after cutover, usually a few weeks, with closer monitoring, daily check-ins and faster escalation. It ensures any gaps from the transition are spotted and fixed quickly before normal service rhythm begins.

Can we switch MSPs without downtime?

Yes, with a phased transition. Running the incoming provider in parallel with the outgoing one, completing knowledge transfer and validating access and monitoring before cutover allows a switch without service interruption. Plan for overlap in contracts to make this possible.

Irfan Harees

Written by

Irfan Harees

Senior Program Manager – Research, Marketing & Strategy · 10 articles

Irfan runs the growth side of Crozaint — how the offering is shaped, how it reaches the market, and how the team behind it is built. An IIT Roorkee MBA with a Six Sigma habit, he brings a process-first, numbers-first discipline to what most companies treat as instinct: positioning, funnels, hiring.

JosephReviewed for technical accuracy by Joseph, Cloud Consulting.

After the reading

Reading About Managed Services Is the Easy Part.Doing It in Your Estate Is Ours.

Thirty minutes with the people who wrote this. We look at your setup, say what we would fix first and leave you with a plan, whether or not you go further with us.

  • A look at your estate, not a demo
  • What we would fix first, and why
  • A plan you keep, whether or not you hire us
Irfan Harees

Talk to Irfan

Wrote this article · Senior Program Manager – Research, Marketing & Strategy

Thirty minutes on your estate. Irfan looks at what you have and tells you what we would do first.

Book 30 Minutes

No deck, no pitch, no commitment.
